Wollombi Road Upgrades

  • Project typeMajor Project
  • Project scheduleMid 2023 - late 2026

Background

Cessnock City Council is upgrading Wollombi Road to make it safer, improve traffic flow and handle more vehicles – we want to make sure it can meet the needs of today and the future.

With construction set to start in early 2025, this upgrade will provide high-quality infrastructure to support the growing demands of our local community.

Stage 1 of the project includes a 2.9km upgrade of Wollombi Road between Abbotsford Street, Bellbird and West Avenue, Cessnock as well as a new intersection at Bellbird North. This stage is funded through a combination of funds from the NSW Accelerated Infrastructure Fund and development contributions.

Stage 2 of the project includes a 1km upgrade of Wollombi Road between West Avenue and Vincent Street, Cessnock. This stage is currently not funded, however grant funding is actively being pursued.

Project status

We’re currently in the final stages of completing the road design. Once it’s ready, we will share it with the community, which we expect to happen in late November 2024.

The construction contractor is set to be appointed by the end of the year, with construction scheduled to begin in early 2025.

We appreciate your patience and look forward to keeping you informed as the project progresses.

Supporting Wollombi Road businesses

We understand that construction may affect your business, and we are committed to providing ongoing support throughout the project.

Council is developing a series of initiatives to help mitigate any disruptions, and we will share these plans with businesses in late November.

The construction schedule for works in front of your business has not yet been finalised. We’re awaiting the appointment of a contractor, which is expected by the end of this year. The contractor will provide the construction timeline, and keep businesses informed on the progress and likely impacts. Businesses will have the opportunity to meet with the project team to address any concerns.

Please note that monetary compensation for potential loss of business due to construction will not be available. However, Council will work closely with affected businesses throughout all stages of the project to manage and minimise impacts.

For any immediate concerns or questions, feel free to contact the project team directly.

Review of Environmental Factors

Finalised REF

The Review of Environmental Factors (REF) is the planning approval document for the project and is a requirement under Part 5 of the Environmental Planning and Assessment Act 1979.

The REF was prepared to consider all matters affecting, or likely to affect the environment as a result of the proposed activities associated with the upgrade of Wollombi Road (Stage 1).

The exhibition period of the REF is now complete. Council has taken into consideration the response from the community and the REF has now been finalised. A copy of this can be found below.

Engagement Report

The project team would like to thank everyone who participated in the Public Exhibition of the Wollombi Road Upgrade Project, Review of Environmental Factors which ran from 14 March to 3 May 2024. We appreciate the time and effort put into the submissions.

Cessnock City Council has reviewed all submissions and developed the Engagement Report - Wollombi Road - Review of Environmental Factors & Design Options.

During the public exhibition period, we received 269 submissions. Key themes included traffic flow, construction impact, project prioritisation, and pedestrian safety. The full list of themes and our responses can be found in the report.

Hard copies are also available at Cessnock Library, Kurri Kurri Library, and the Administration Building in Vincent Street, Cessnock.

Location

Stage 1: Upgrading Wollombi Road between Abbotsford Street, Bellbird and West Avenue, Cessnock.

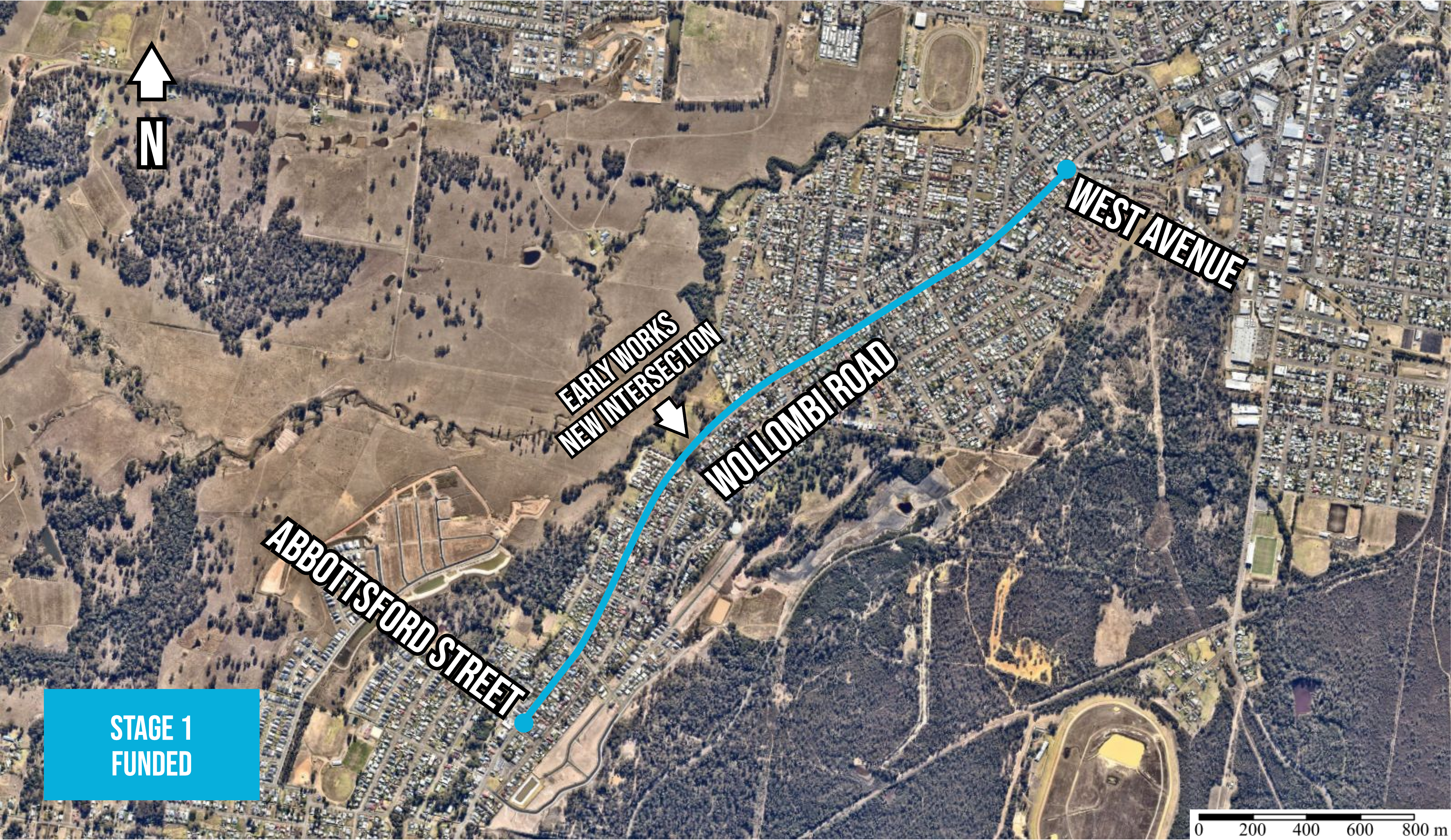

Website image maps_stage 1.jpg

Stage 2: Upgrading Wollombi Road between West Avenue and Vincent Street, Cessnock.

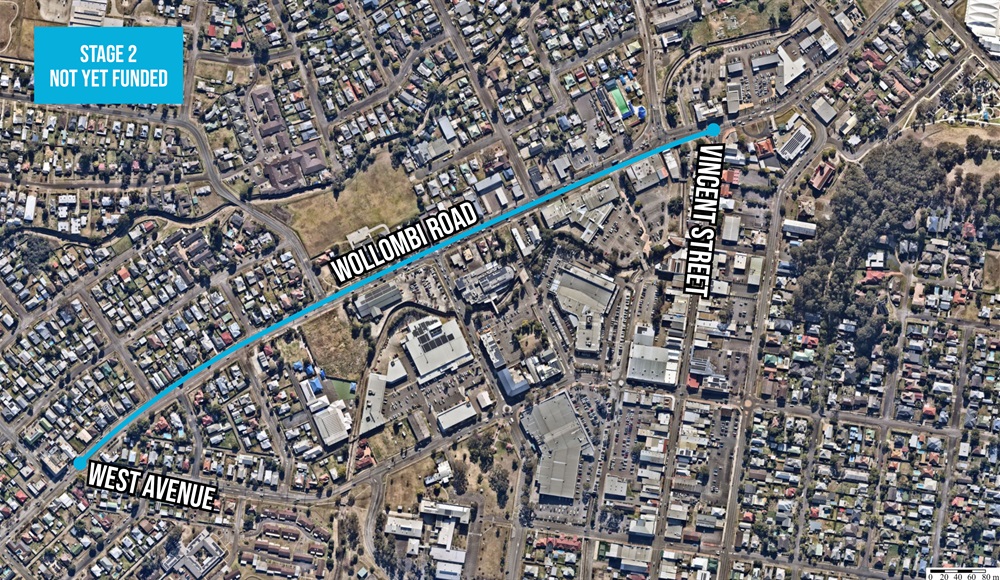

Website image maps_stage 2.jpg

Project Timeline

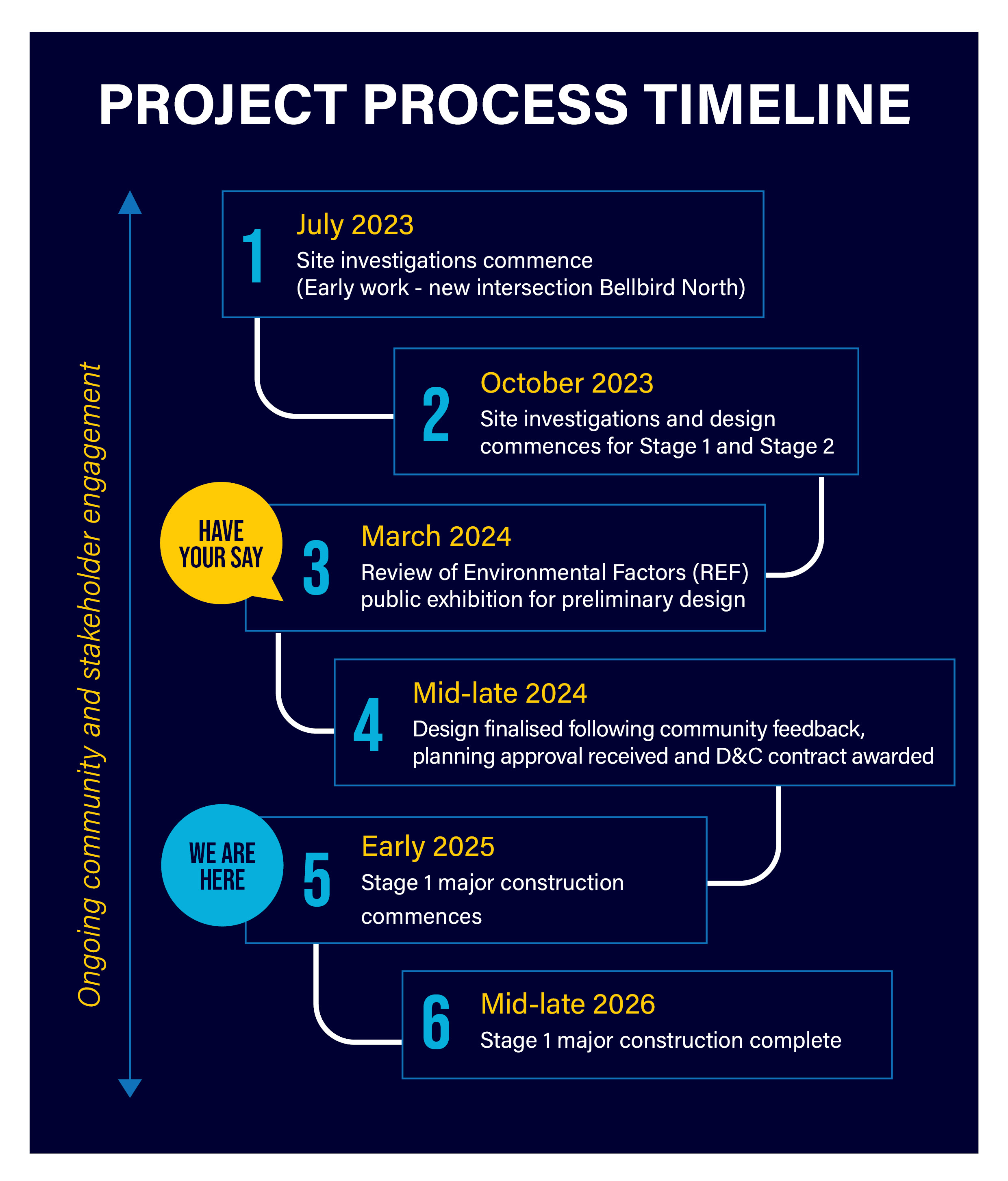

Project Process Timeline__updated August24.jpg

Project History

Wollombi Road upgrades were identified in the Bellbird North Section 94 Contributions Plan in 2009 following the rezoning of the Bellbird North Urban Release Area.

Throughout 2015-2018, the Cessnock community was consulted on the development of the Cessnock Traffic and Transport Strategy (CCTS) 2018. In 2023 Council undertook further community consultation and the CTTS was updated to reflect changes in population growth forecast.

The purpose of the Cessnock Traffic and Transport Strategy 2023 is to provide a long-term vision that can be used to guide transport related decision making between now and 2041. It identifies a range of actions that Council, the NSW State Government, and other stakeholders need to consider to improve and optimise the transport network for years to come.

Both the 2018 and 2023 CTTS identified the Wollombi Road upgrade as a critical part of the broader traffic strategy

Traffic congestion is a growing area of concern in maintaining efficient operation and function of the road. If not addressed, congestion will continue to impact productivity, safety and the reliability of travel times for businesses and the community. It could also affect the amenity of the town, and undermine the lifestyle enjoyed by residents and visitors.

Progress

Update: October 2024

We’re currently in the final stages of completing the road design. Once it’s ready, we will share it with the community ad businesses, which we expect to happen in late November.

Additionally, Council is developing a series of initiatives to help mitigate any disruptions to businesses along Wollombi Road. These plans will also be shared with businesses in late November and businesses will have the opportunity to meet with the project team to address any concerns.

The construction contractor is set to be appointed by the end of the year, with construction scheduled to begin in early 2025.

We appreciate your patience and look forward to keeping you informed as the project progresses.

Update: July 2024

During July 2024, you may see some of our workers along Wollombi Road, carrying out some geotechnical investigations, surveys, potholing, and service locating. This is to help inform the detailed design of this project.

The work may include some short-term closing of road shoulders, or travel lanes along Wollombi Road.

Traffic controllers will be in place to direct traffic and pedestrians. Motorists are advised to drive to the conditions and follow the directions of signs and traffic control.

Update: February 2024

From Tuesday 6 February night work will be undertaken on Wollombi Road. The investigation work will include utility locating and mapping, and CCTV inspections of existing stormwater infrastructure.

The work will take place Sunday to Thursday nights only between 9pm and 5am, and will take up to two weeks to complete, weather permitting.

Traffic control will be in place and there may be some impacts to local traffic flow.

Please drive carefully. Access for residents will not be impacted. Thank you for your patience while we complete this important work.

Update: December 2023

Since early October 2023 site investigations have been carried out on Wollombi Road from Vincent Street to Abbotsford Street to help inform the project team of any significant constraints that may affect the upgrade. Investigations included:

  • Surveying and measuring height and widths
  • Drilling and collecting information on the road condition
  • Assessing the condition and location of inground services
  • Reviewing the stormwater system
  • Undertaken noise monitoring
  • Assessing the condition of the existing footpath, kerbs, bus stops and lights.

Most of this work is now complete, with some inground service investigations to be completed in early 2024. Thank you to the community for their patience and understanding during this important work.

Work will now begin on the development of a preferred concept design for the project and environmental investigations will be carried out to inform the project’s Review of Environmental Factors which will be on public display in 2024.

View the December community update(PDF, 3MB) for the latest project news.

Update: September 2023

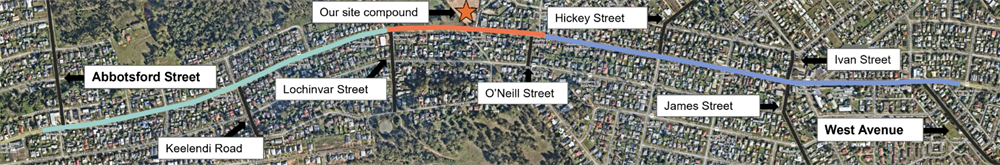

The tender for the preliminary engineering contract was awarded to KBR in late August 2023. Stage  1 and 2 site investigations work will commence on Wollombi Road, between Vincent Street to Abbotsford Street in early October 2023. Site investigations include surveying, identifying underground services and conducting geotechnical investigations. These detailed engineering investigations within the road corridor will help inform the design and any significant constraints that may affect the project. Impacted residents and businesses will be notified before work commences. Early consultation with business owners and local residents continues to be undertaken. All early feedback is considered valuable and will help inform the design and planning of the upgrade.

Update: August 2023

Consultation with business owners and local residents continues to be undertaken. A 'Coffee with a Councillor' event was held 12 July, where some attendees joined the project notification list. For community members wishing to join the notification list, or would like to ask council questions relating directly to this project, please call 1800 290 991 or email wollombiroadupgrade@cessnock.nsw.gov.au

Stage 1 & 2 Investigation works will commence pending the Council acceptance of the Preliminary Engineer tender.  A Review of Environmental Factors (REF) is being undertaken, to examine potential environmental impacts of the development along the nominated project zone.

Update: June 2023

Field investigation works will commence in late July / August. This may consist of geotechnical investigations, service locations and surveying. This will allow initial designs to be generated which will address issues such as parking and layouts. Consultation will commence in advance of this by discussing aspects of the project and opportunities and issues with local residents and business owners.

Update: April 2023

The project is currently in the early stages of the design process. There is a lot of investigation and development work to be done before construction can commence. This includes early community engagement, environmental approval, survey and several other engineering investigations.

FAQ's

Why are we delivering this upgrade?

The Cessnock Local Government Area is experiencing rapid growth, and the upgrade of Wollombi Road is essential to accommodate current and forecasted traffic growth and to alleviate congestion on our roads.

The upgrade of Wollombi Road is well understood as a local transport priority, with Council identifying the need as far back as 2009 in the Bellbird North Section 94 Contributions Plan, and reinforced subsequent studies and strategies.

In 2018 the Cessnock LGA community was engaged in the development of the Cessnock LGA Traffic and Transport Strategy 2018. Consultation revealed that one of the key traffic and transport issues identified by the community is congestion along Wollombi Road, particularly during peak periods.

Council publicly exhibited the updated Cessnock LGA Traffic and Transport Strategy (CTTS) 2023. The upgrade of Wollombi Road continues to be identified as a priority infrastructure project that will address the long term growth of Cessnock.

Impact to traffic from developments in 2031

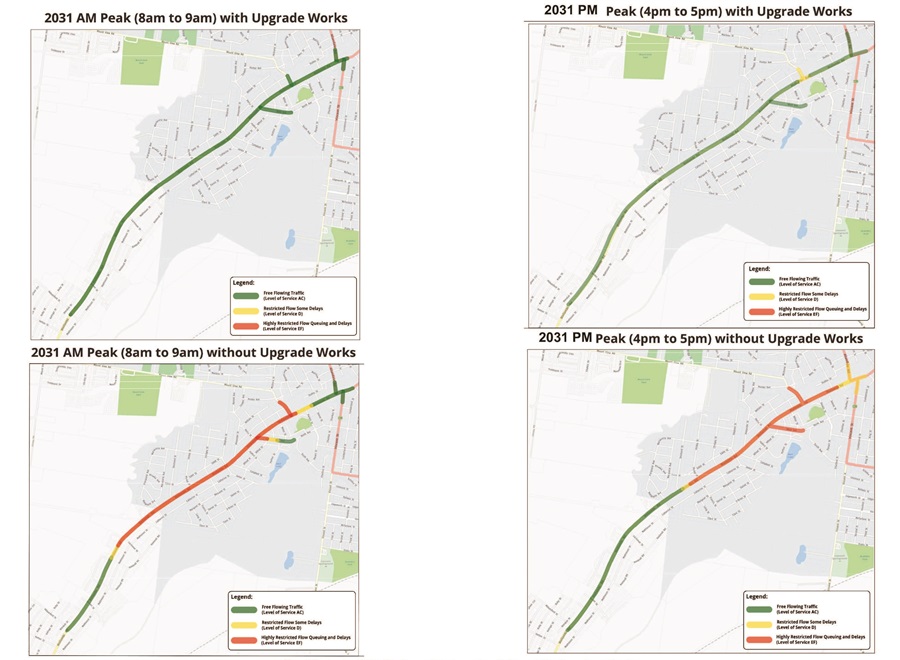

Wollombi Road.Heat.Map.jpg
This graphic shows the impacts to traffic during AM and PM peaks with and without the upgrade work. The green line illustrates free flowing traffic, the orange line restricted traffic with some delays and the red line highly restrictive traffic with queuing and delays. All modelling is based on 2015 traffic volumes with background growth and impact of developments considered.

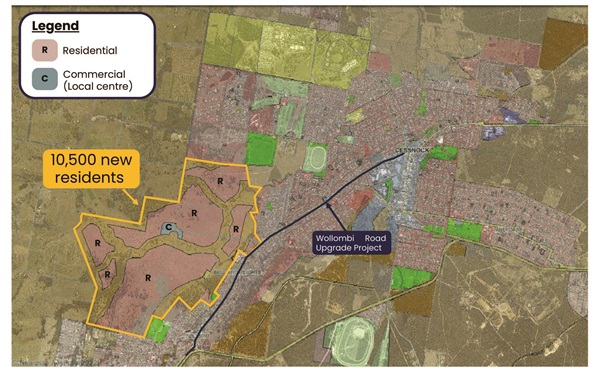

Planned development and population growth in Bellbird North

Bellbird Nth URA.jpg

This plan shows the scale of the Bellbird North Urban Release area that is approved for housing development and the expected population growth in this specific area.

Projected increase in traffic in West Cessnock

Wollombi Road Upgrade Project - Car Count Wollombi Road and West Ave.jpg

This graphic shows the vehicles travelling on Wollombi Road at peak hours each day from a 2015 study versus projected vehicles travelling on Wollombi Road at peak hours in 2031.

How will the upgrade improve the area?

The upgrade of Wollombi Road will deliver high-quality infrastructure that supports the local community and improve accessibility which is crucial for our growing region.

Upgrading Wollombi Road will also directly benefit and accelerate the release of future residential development within the Bellbird North Urban Release Area (URA) and will support the development of approximately 3,500 new dwellings.

What are the key benefits?

  • Reduced congestion and improved traffic flow along Wollombi Road
  • Improved road safety, efficiency and travel times
  • Fit for purpose infrastructure for a growing area, benefiting local businesses and tourism

How is the project being funded?

The Wollombi Road upgrade is a major council project and will be funded through a combination of funds from the NSW Accelerated Infrastructure Fund and development contributions. Other funding avenues are being explored to fund Stage 2 of the project.

When will works commence?

Stage 1 of the project is in the detailed design stage.

Construction is due to start in early 2025 once the tendering process is complete.

When will works be completed?

Works are scheduled to be completed in late 2026, weather permitting.

Will there be any traffic changes or road closures throughout the duration of the works?

Traffic changes will be managed closely throughout the project, and construction will be carried out in sections to minimise impacts. The community will be kept up to date on any traffic changes through regular communications including updates on social media and Council’s website.

Why doesn't the upgrade include all of Wollombi Road, into the city centre?

Council plans to continue into Vincent Street from West Avenue. This is Stage 2 of the project and will require further funding.

Stage 2 is included in the investigations and preliminary engineering design work. An options assessment was conducted for Stage 2, and a preferred design has been determined. This allows Council to process more quickly with Stage 2 once funding is available.

We will keep you updated on the status of the delivery of Stage 2.

How are you working with local businesses and residents along Wollombi Road to minimise impacts?

A program of early community and stakeholder engagement commenced in July 2023.

This early engagement meant that Council could gather community feedback to inform the design and planning of the road upgrade.

Through a series of community engagement activities and events, Council was also able to raise awareness about the project and the need to cater for growth in the LGA.

During the face-to-face engagement events, the Council team had over 300 conversations with members of the community and business owners.  Our team met or spoke to 64 businesses on Wollombi Road to seek feedback on the project, and how it may impact them both during and after construction.

Council is currently in the final stages of completing the road design. Once it’s ready, we will share it with the community, which we expect to happen in late November.

We’re also in the process of developing a series of initiatives to help mitigate any disruptions to businesses along Wollombi Road, and we will share these plans with businesses in late November. Additionally, once the construction timeline is confirmed, businesses will have the opportunity to meet with the project team to review the schedule and address any concerns.

Council will continue to work with residents, businesses and key stakeholders as the project progresses, and impacted residents will be notified of any future works.

How will you engage with the wider community on the project?

Extensive community engagement will be carried throughout the project to ensure the community is informed, and they have the information and support they need to provide feedback on the project.

Throughout the project we will keep our community informed in several ways, including but not limited to:

  • One-on-one meetings with residents and businesses
  • Letterbox drops to residents and businesses surrounding the work area
  • Information on Cessnock Council’s website and social media channels
  • Media releases and advertising
  • Signage around the work site and along impacted roads
  • Community information sessions and pop-up events

How can I get in touch with the project team if I have any questions?

To contact the project team and comment or raise concerns please contact us via:

See the privacy notice for this project

Council is committed to safeguarding the privacy of individuals and handling of personal information in accordance with the Privacy and Personal Information Act 1998 (NSW) and Information Privacy Principles, the Health Records and Information Privacy Act 2002 (NSW) and Health Privacy Principles, and any subordinate legislation.

Purpose

The information on this correspondence is being collected for the purpose of informing the Wollombi Road Upgrade Project design and management teams. The information collected will be used for the purpose outlined, related administrative functions, compliance and complaint handling, internal auditing, and in accordance with Council's Privacy Management Plan and Privacy Statement which can be found on Council's website.

Intended Recipients

Wollombi Road Upgrade Project Team and Council officers

Supply

Voluntary

Consequence of non-provision

If you do not supply the information, Council will not be able to contact you in regards to the project or your enquiry and Council cannot guarantee that your enquiry has been considered to its full capacity by the Project Team.

Disclosure

Your information may be disclosed to other government organisations or external consultants involved in the Wollombi Upgrade Project for the purpose of keeping you informed about project progress, responding to your enquiry and to assist in informing the design.

Storage and Security

Your personal information will be kept in Council's Information Management System in accordance with the relevant legislation. Council's address is62-78 Vincent Street CESSNOCK NSW 2325.

Your information will also be held within Consultation Manager and Council recommends you read their privacy statement Terms and Conditions | Consultation Manager .

Access

You may access, correct or update your personal information by visiting Council’s website, contacting Council's Privacy Contact Officer on 4993 4100 or by sending an email to council@cessnock.nsw.gov.au.

If you want to know more about Council's obligations regarding your personal information or what rights you have, contact the Information and Privacy Commission or visit their website ipc.nsw.gov.au.
